www.modeler-forum.com

CONSIDEO - FORUM
It is currently Thu 21. Nov 2024, 11:49

All times are UTC + 1 hour [ DST ]




Post new topic Reply to topic  [ 1 post ]
Author Message
PostPosted: Tue 1. Feb 2011, 09:00
Offline
Administrator

Joined: Fri 3. Sep 2010, 13:20
Posts: 300
Here's an example on how to structure a PROCESS MODELER model to run Monte Carlo scenarios on possible developments and how to use the range() formula to identify an optimal input of resources (performing hard operations research).
You can easily add any detail from your specific challenge. Use the MODELER-Forum to ask for further help...

Happy modeling

Kai


Attachments:

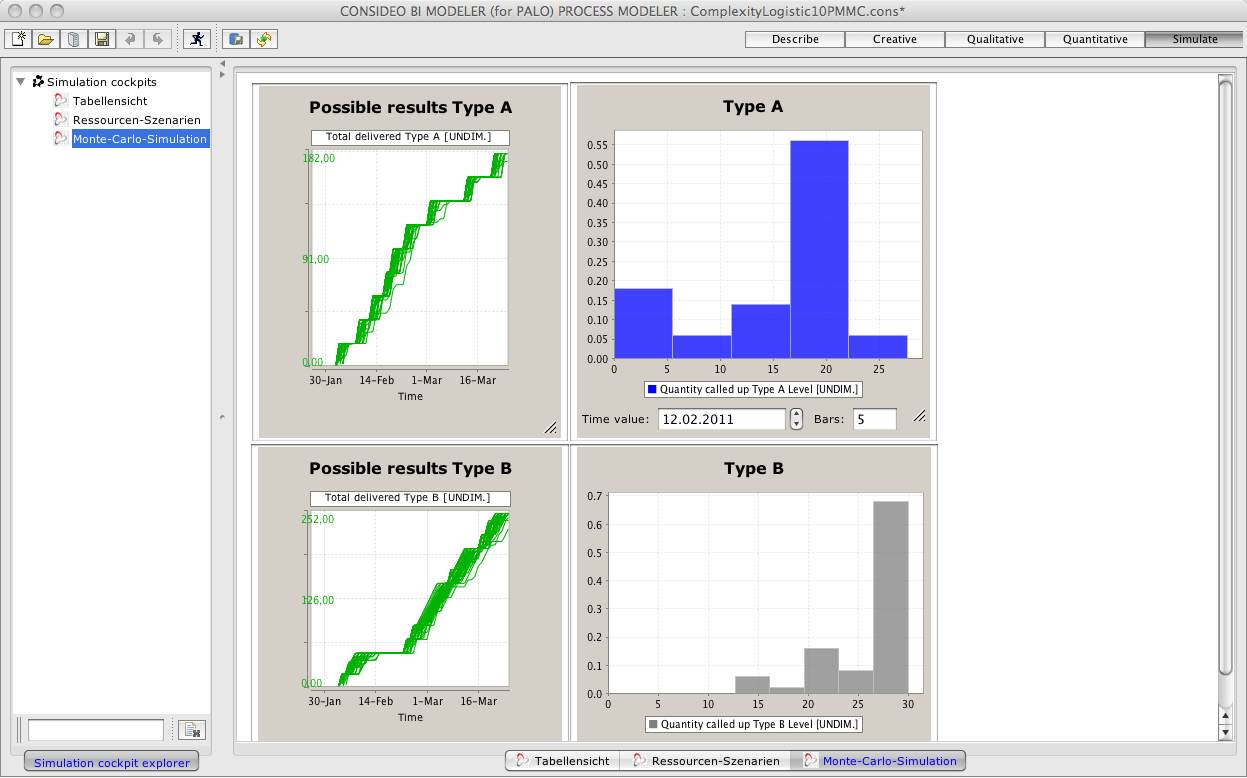

File comment: Screenshot showing the Monte Carlo simulation
ShotLogisticMonteCarlo.jpg [ 104.92 KiB | Viewed 9714 times ]

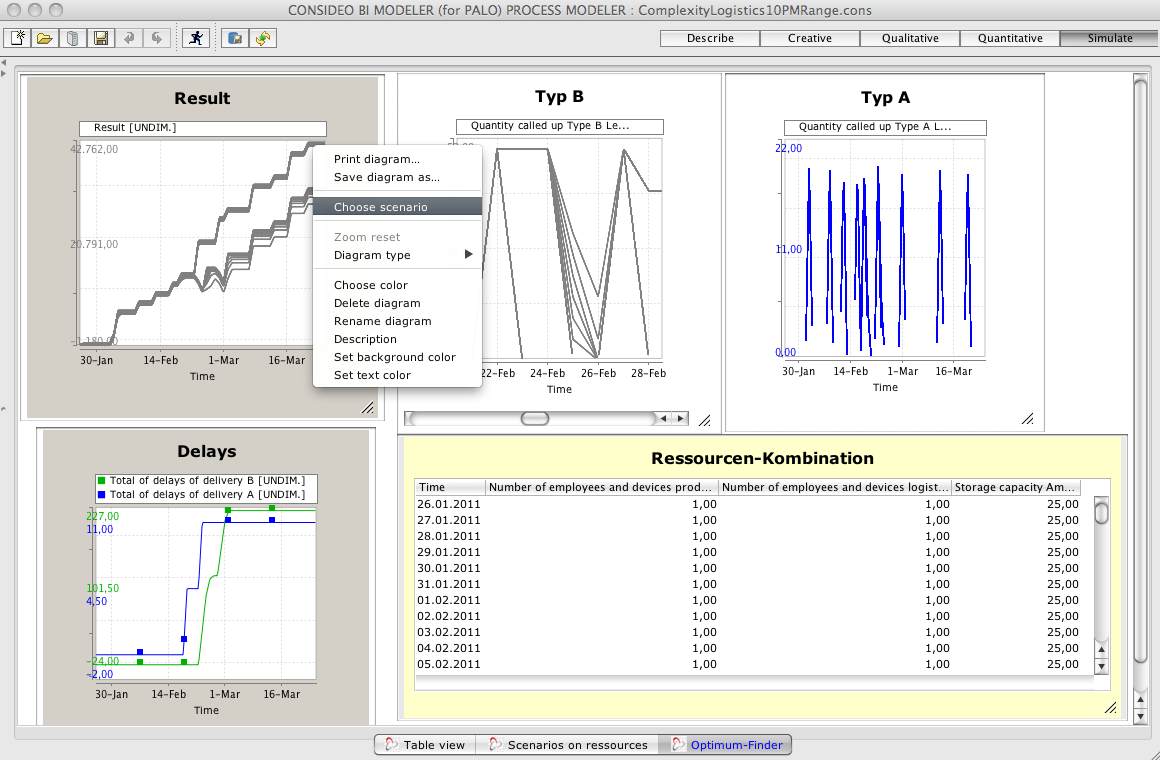

File comment: Screenshot showing how to select a scenario and see what combination of resources lead to it. Of course, you can zoom into the diagram to pick the optimal scenario ...
ShotLogisticOptimization.jpg [ 121.75 KiB | Viewed 9714 times ]
File comment: the model with the range() optimization
ComplexityLogistics10PMRange.cons [260.09 KiB]
Downloaded 1362 times
File comment: the Monte Carlo model
ComplexityLogistic10PMMC.cons [267.04 KiB]
Downloaded 1345 times

_________________
Kai Neumann

Consideo
Top
 Profile

Display posts from previous:  Sort by
Post new topic Reply to topic  [ 1 post ]

All times are UTC + 1 hour [ DST ]


Who is online

Users browsing this forum: No registered users and 3 guests


You cannot post new topics in this forum
You cannot reply to topics in this forum
You cannot edit your posts in this forum
You cannot delete your posts in this forum
You cannot post attachments in this forum

Search for:
Jump to:
Powered by phpBB® Forum Software © phpBB Group
